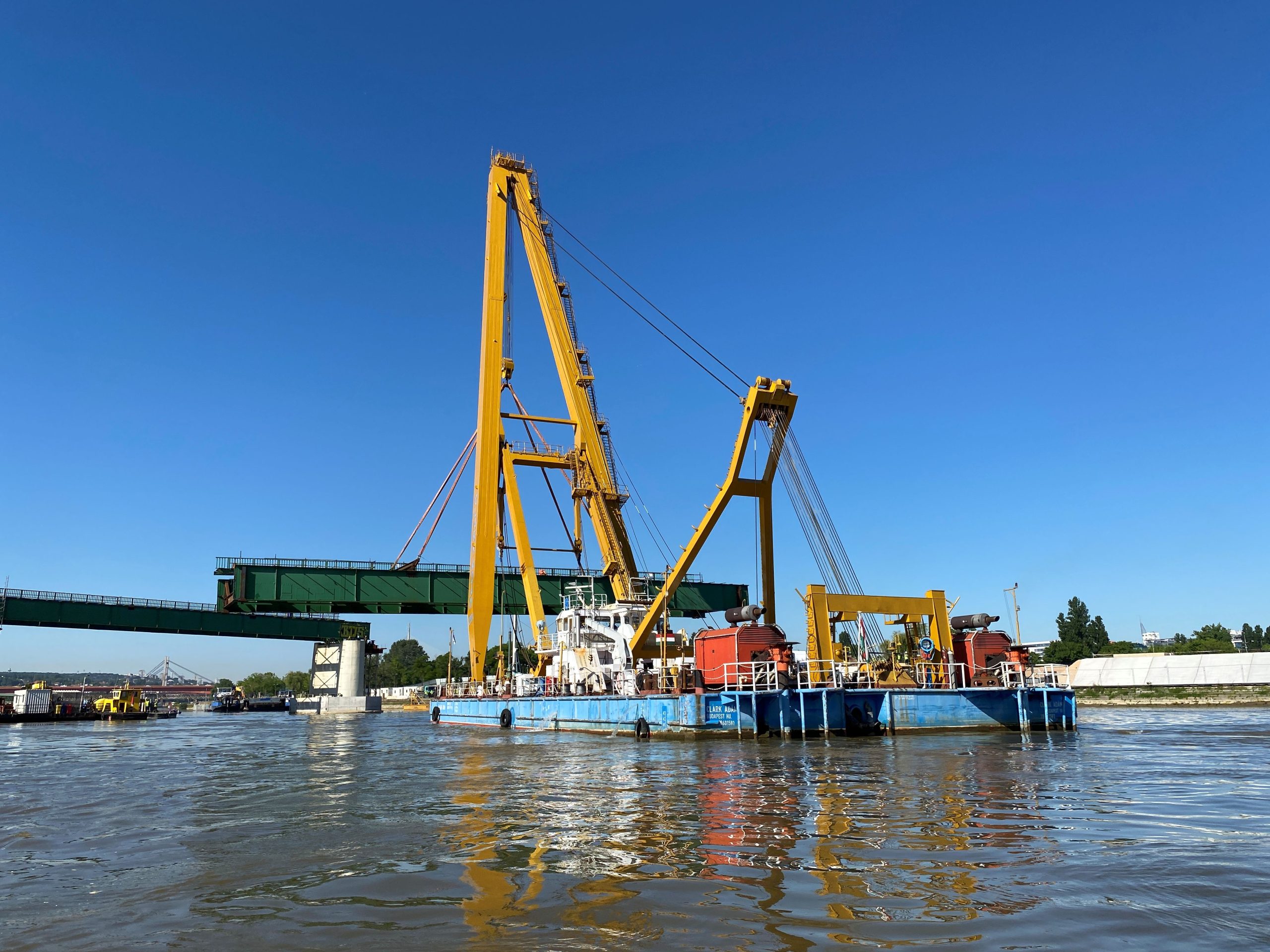

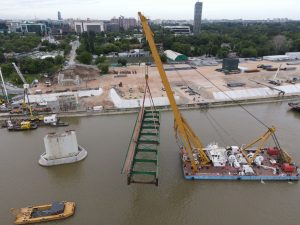

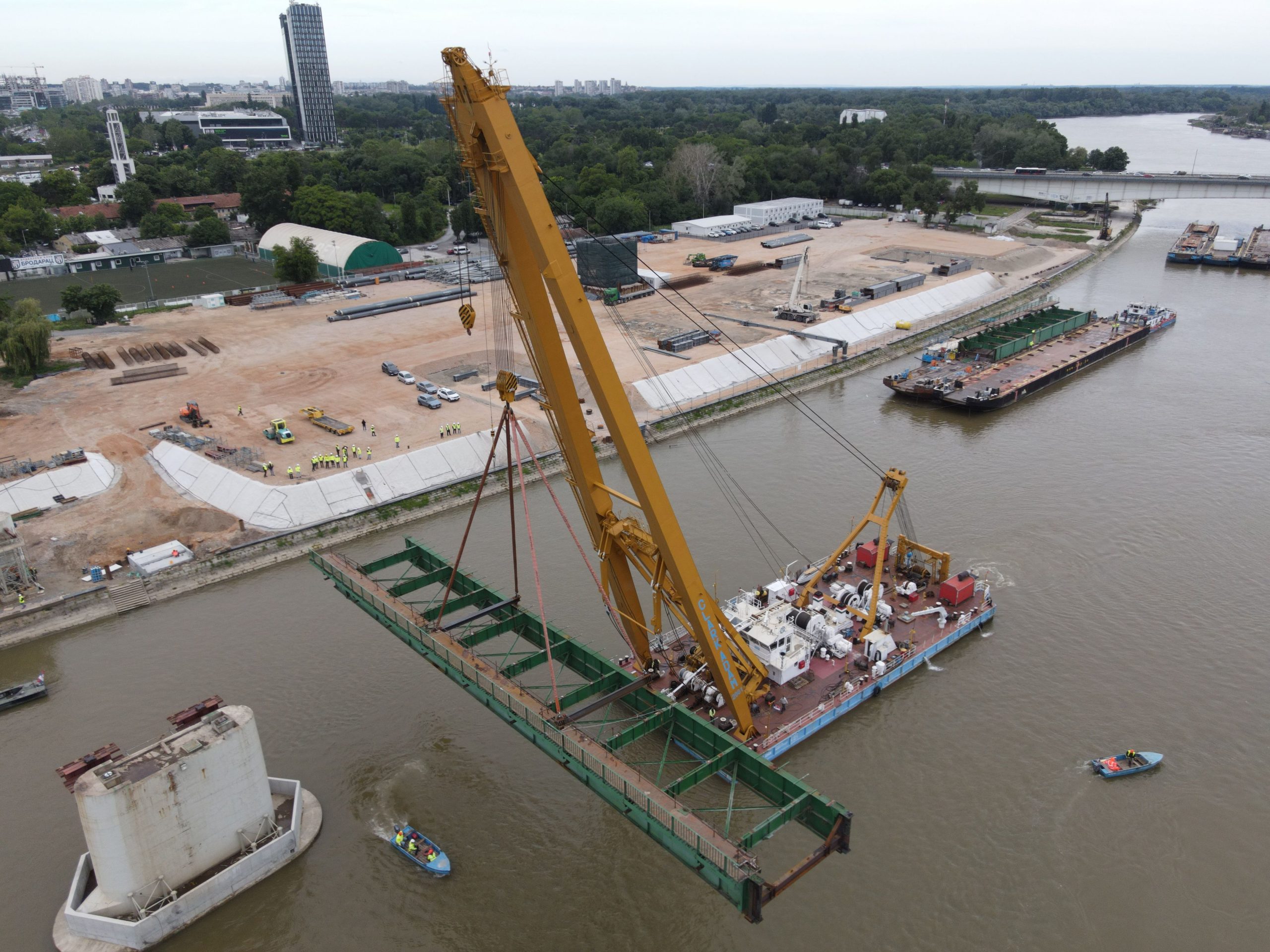

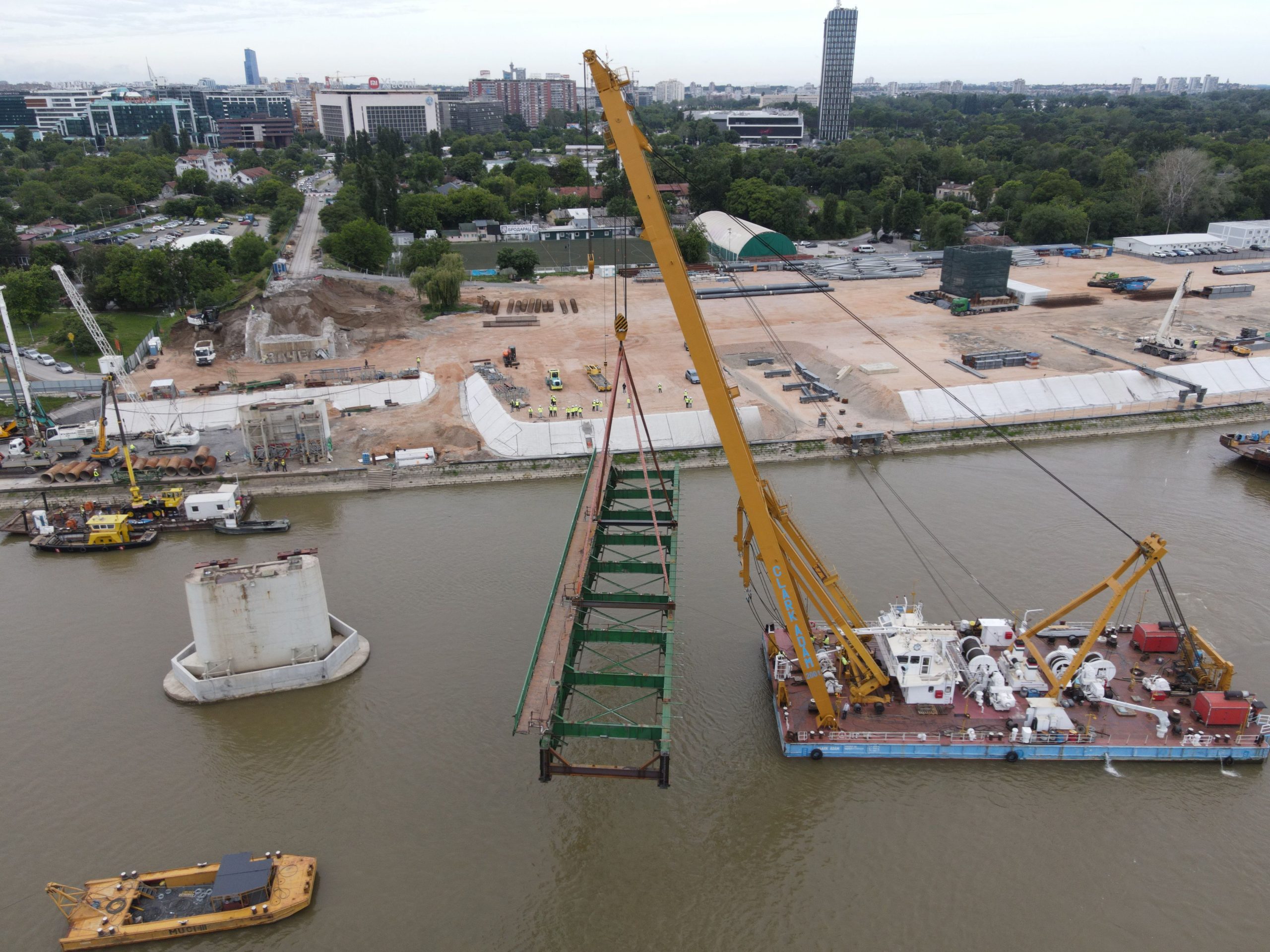

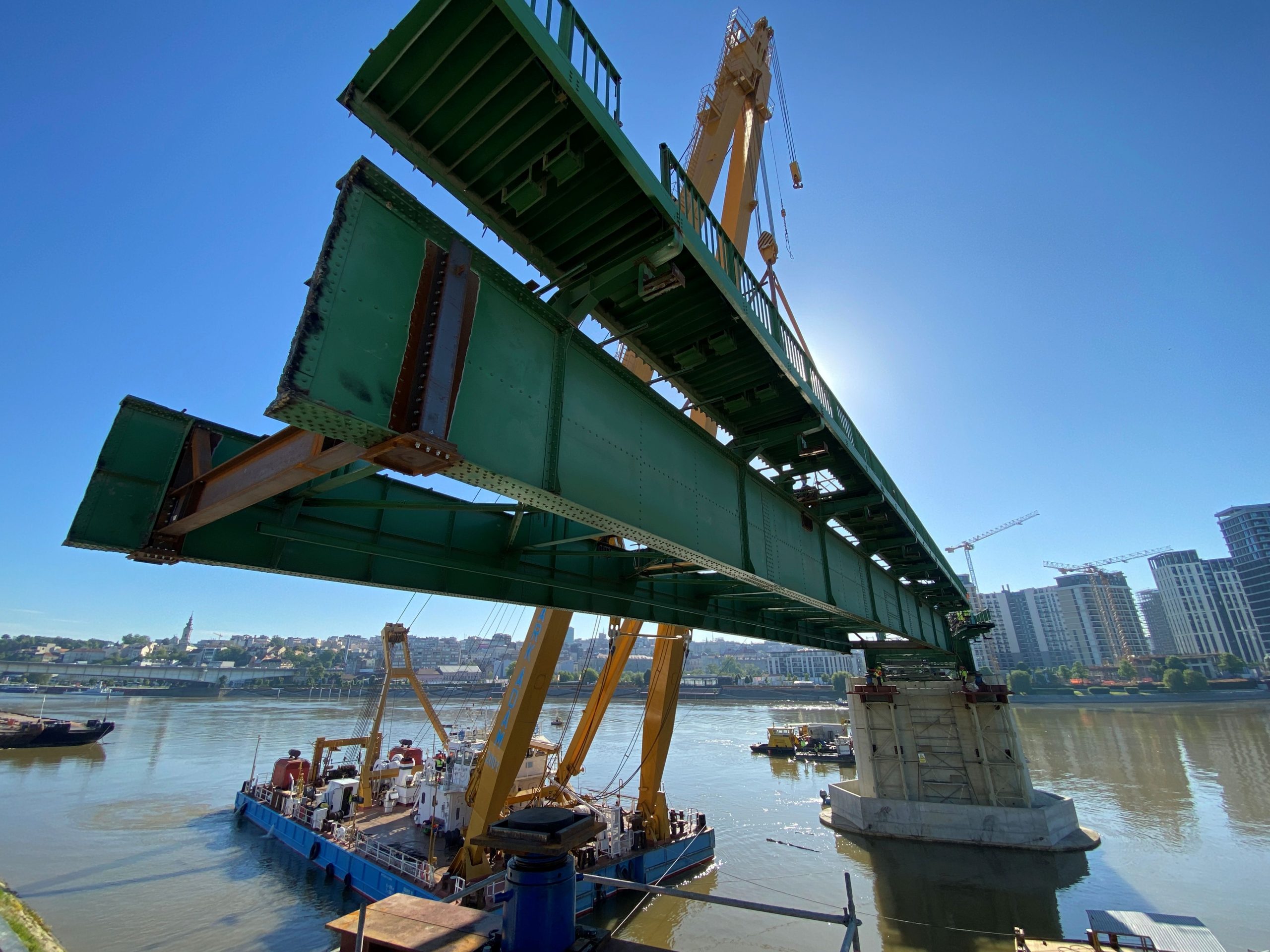

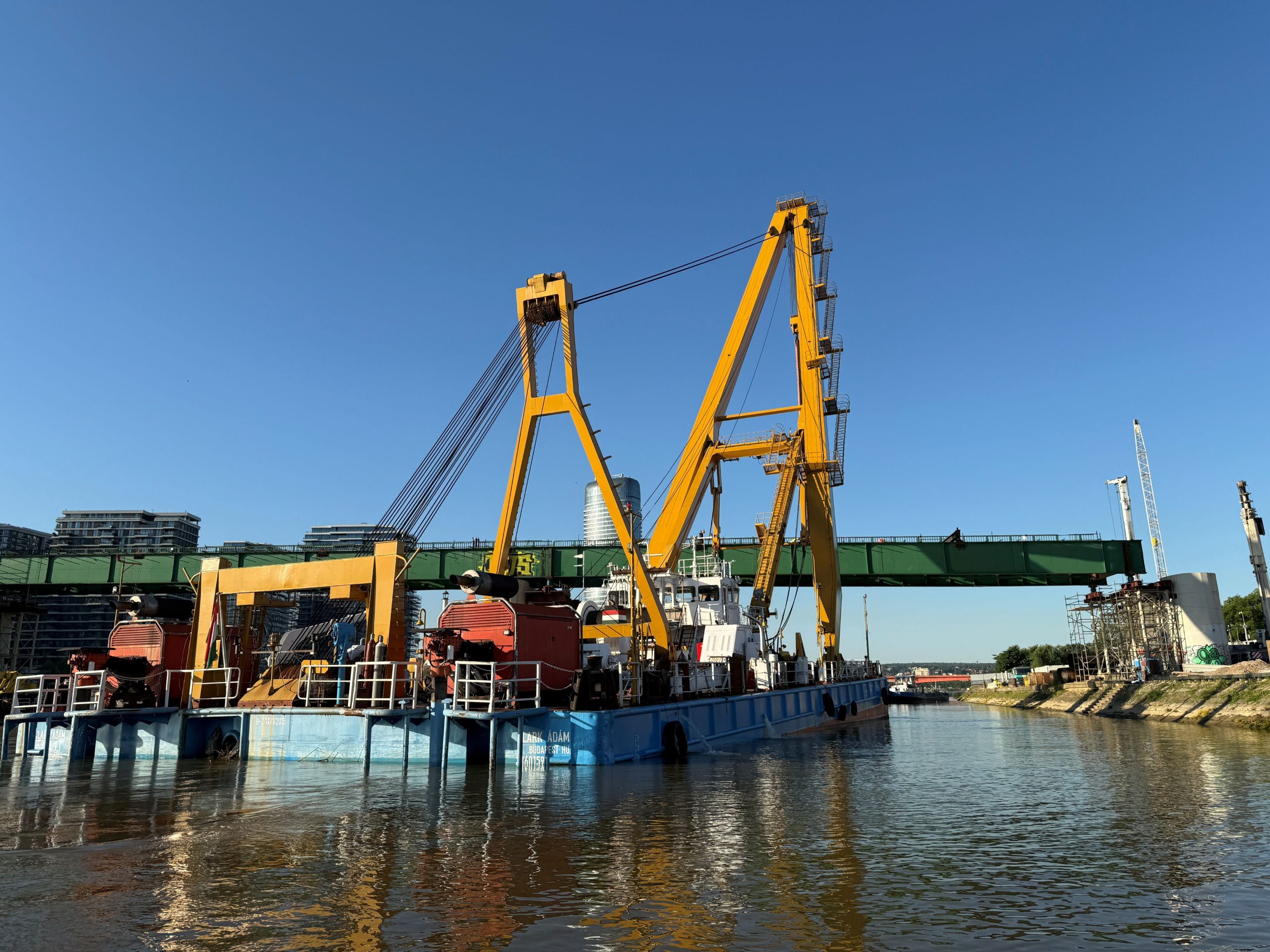

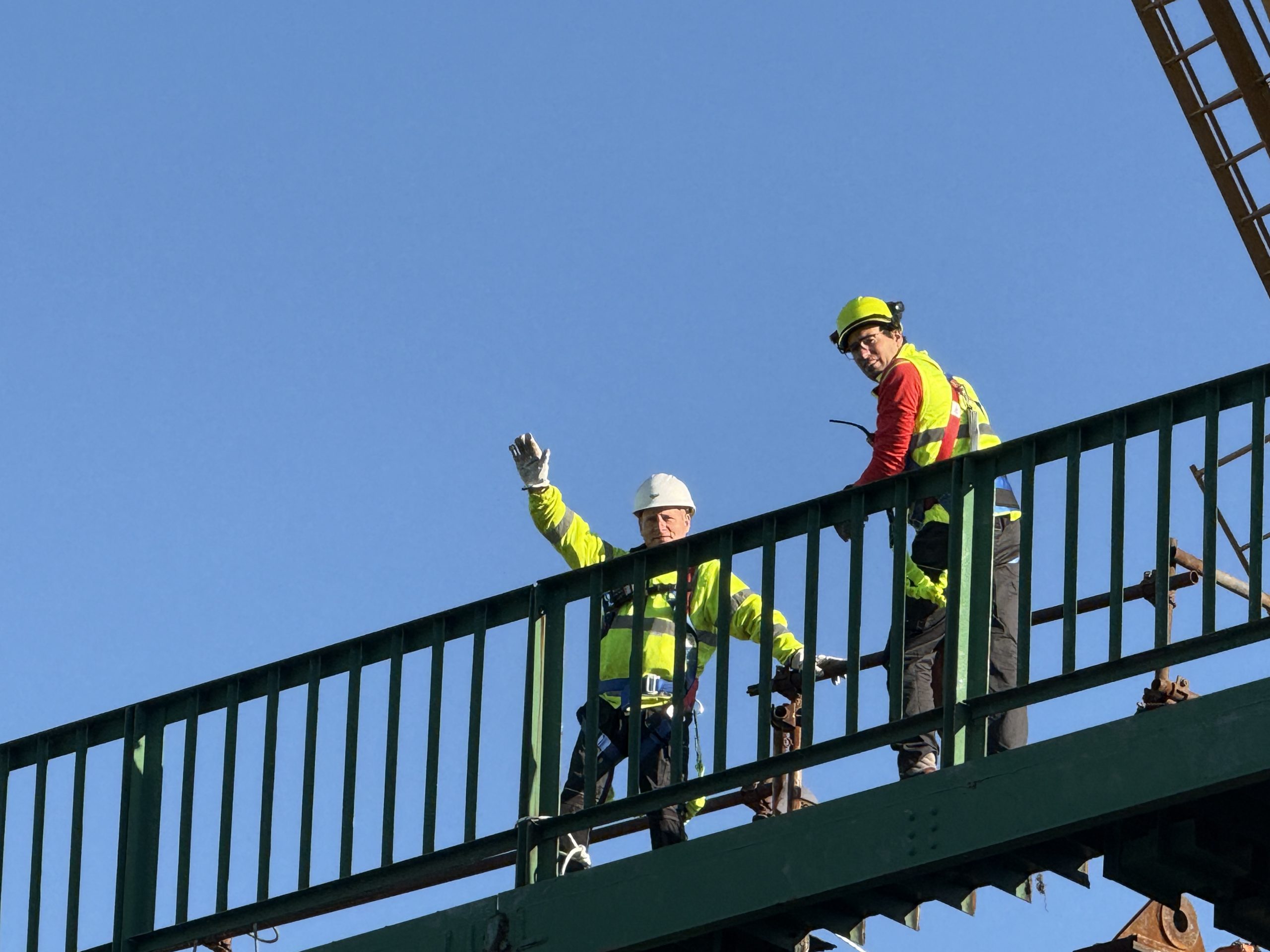

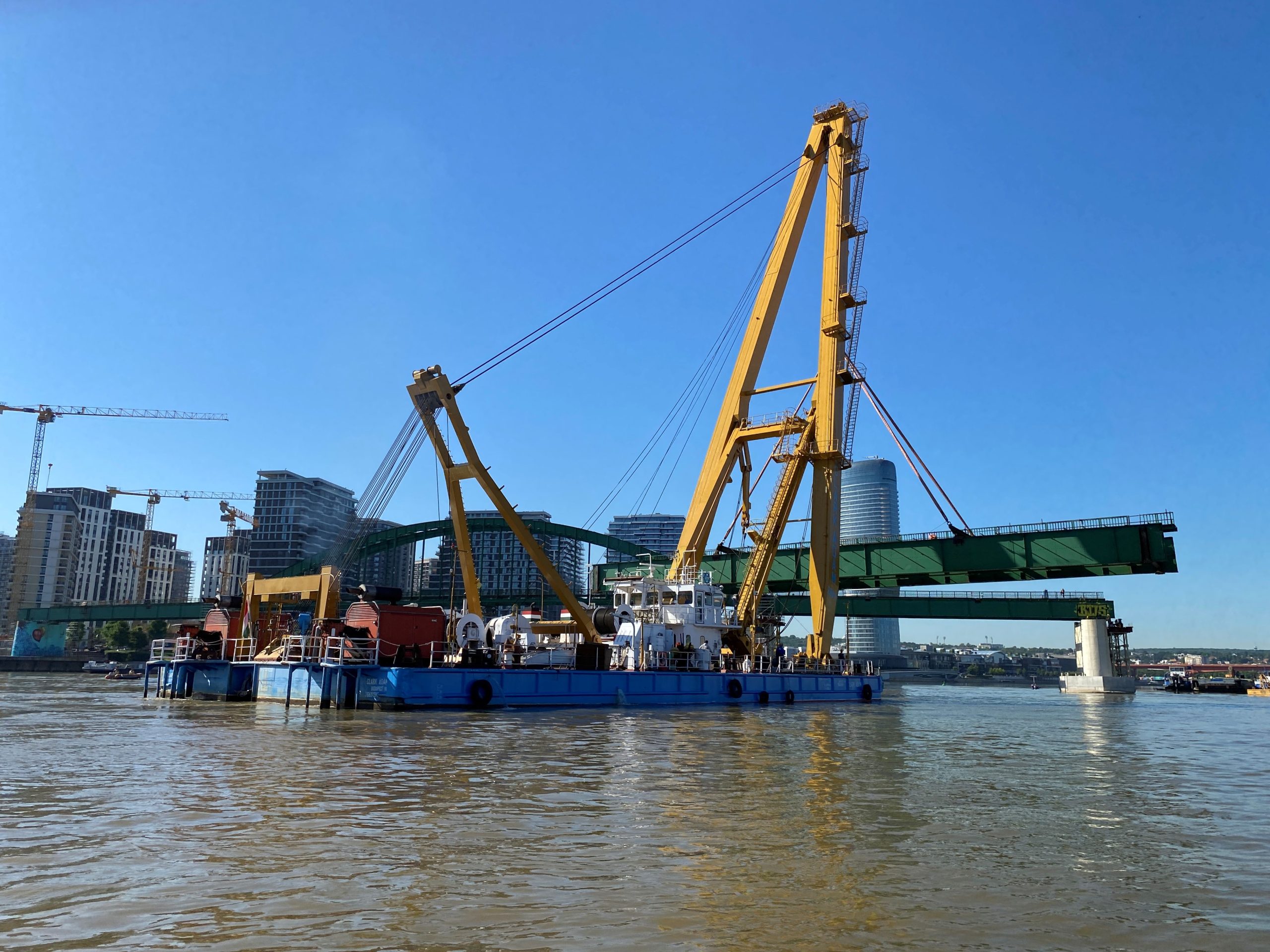

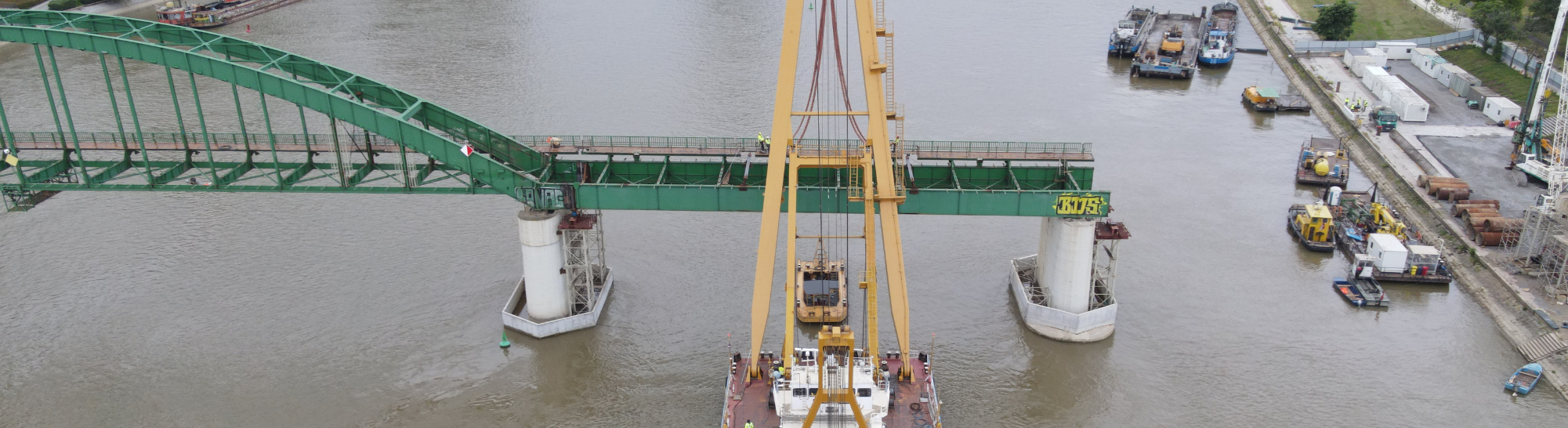

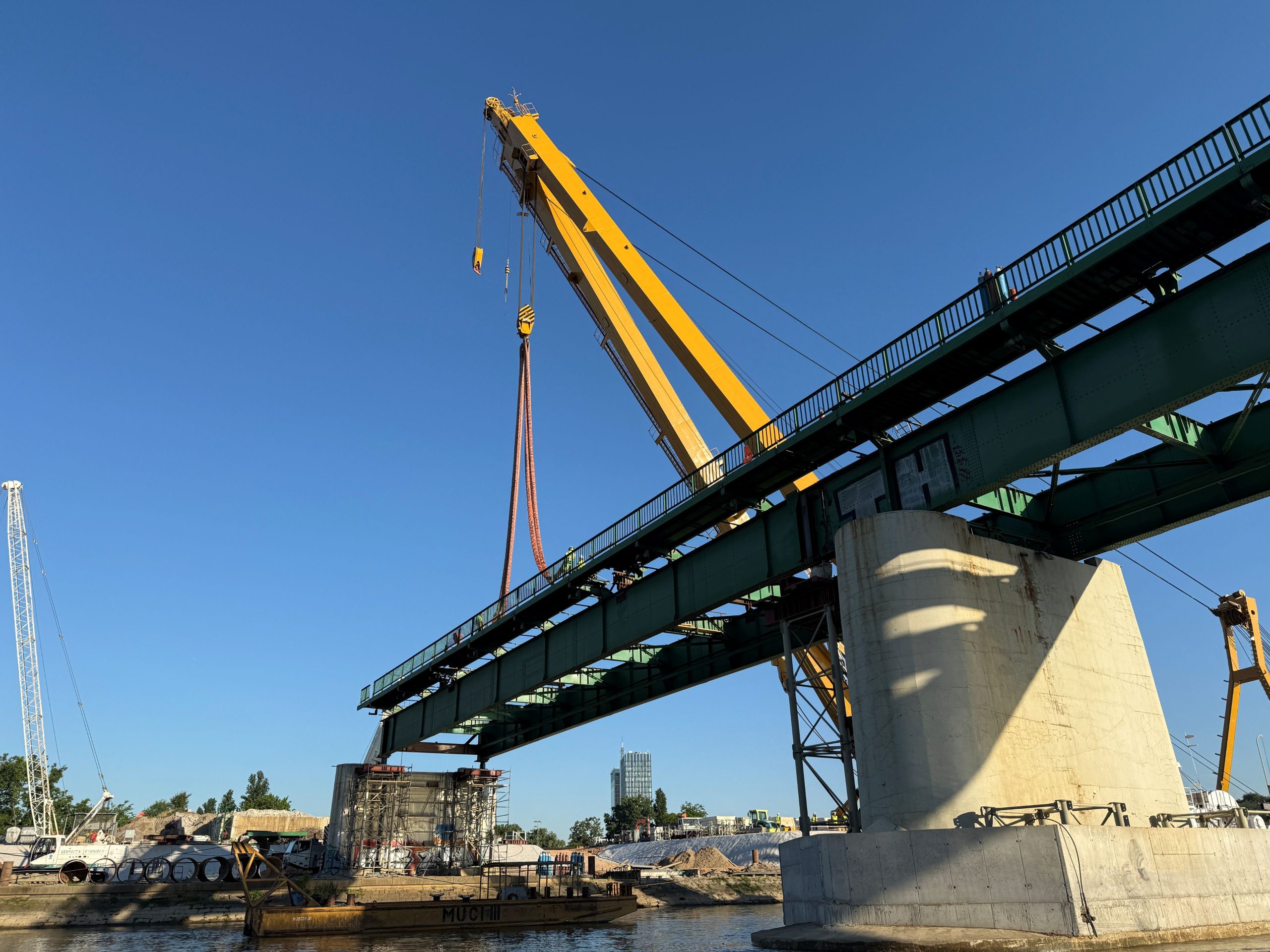

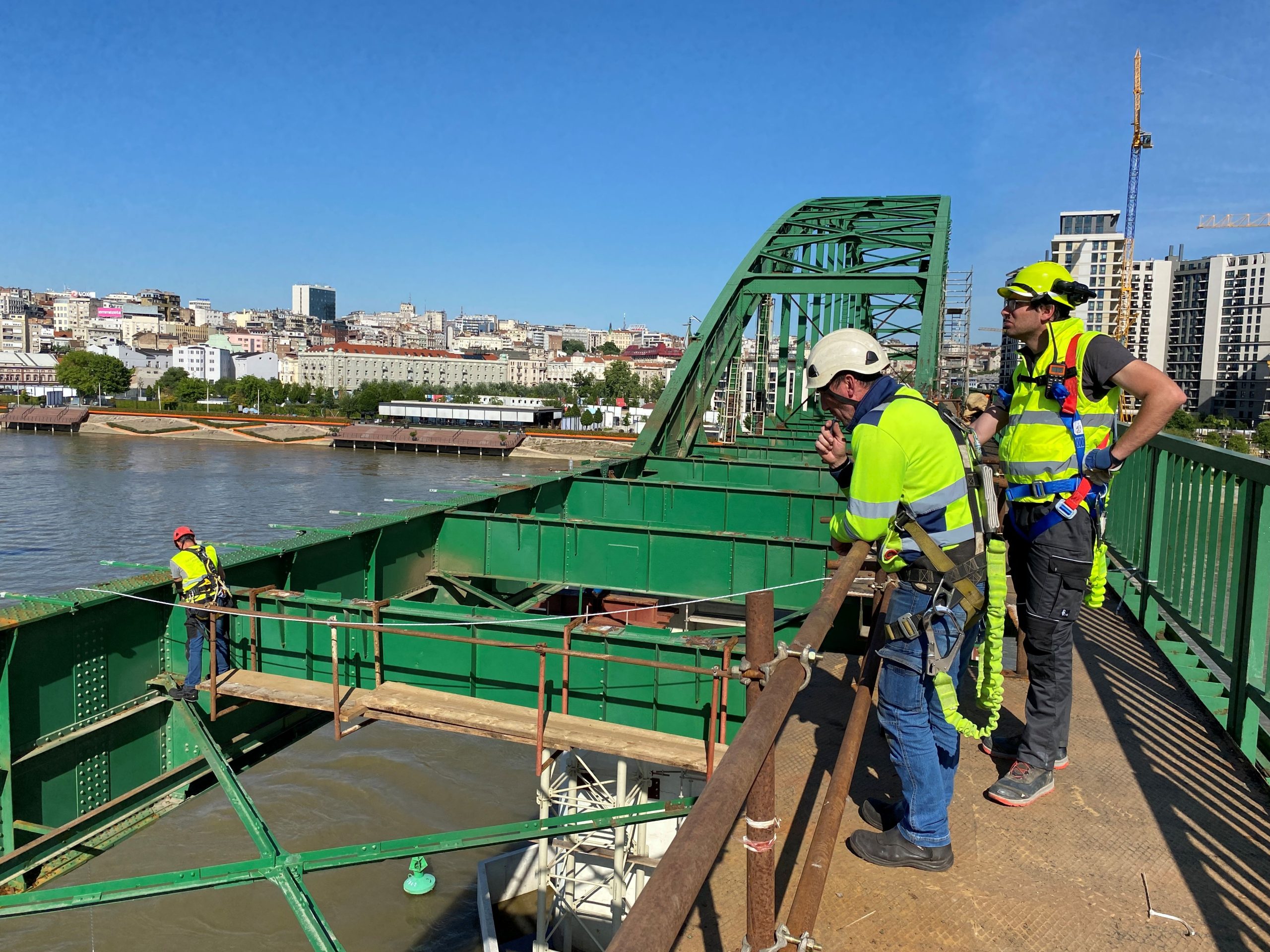

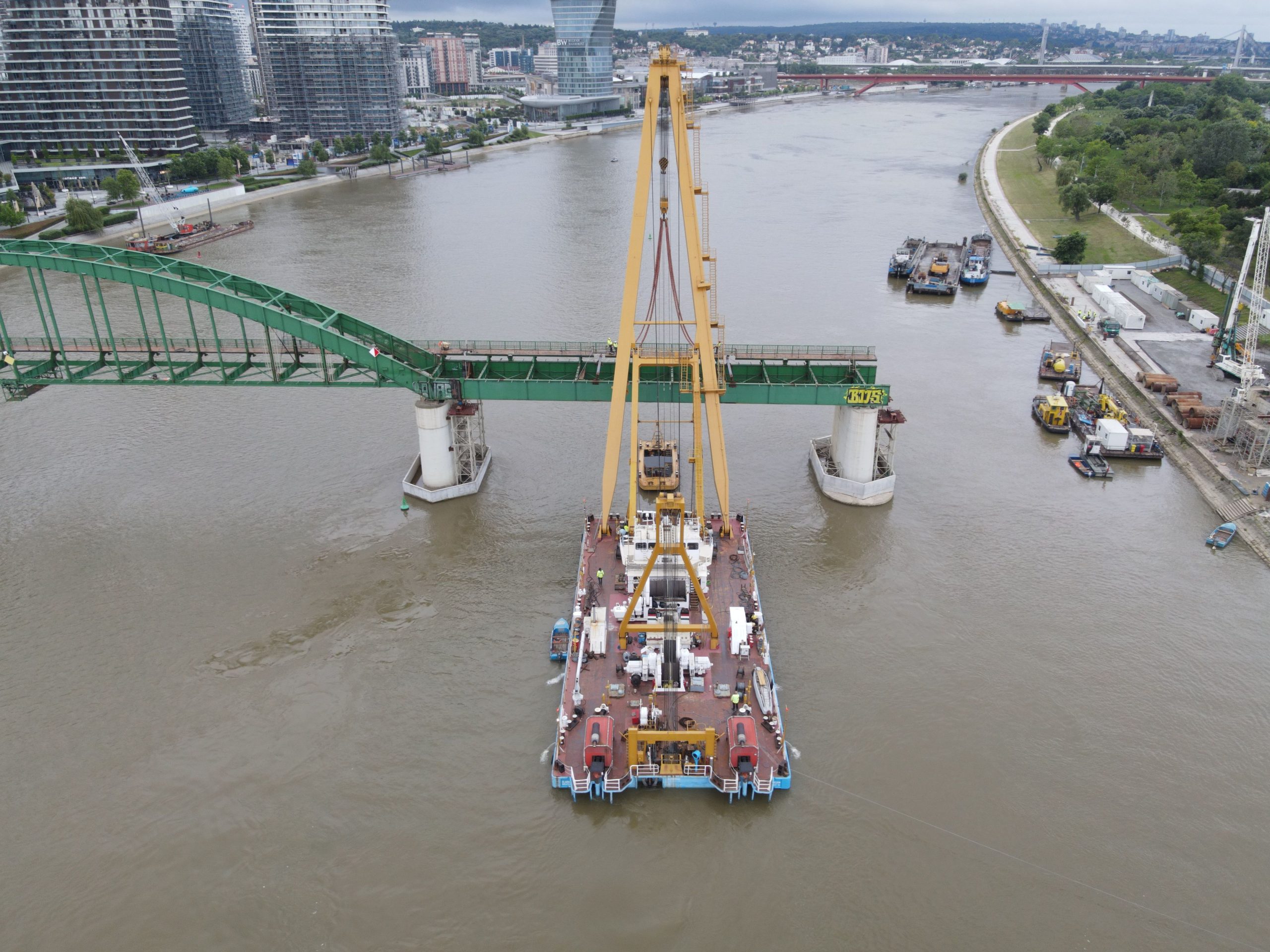

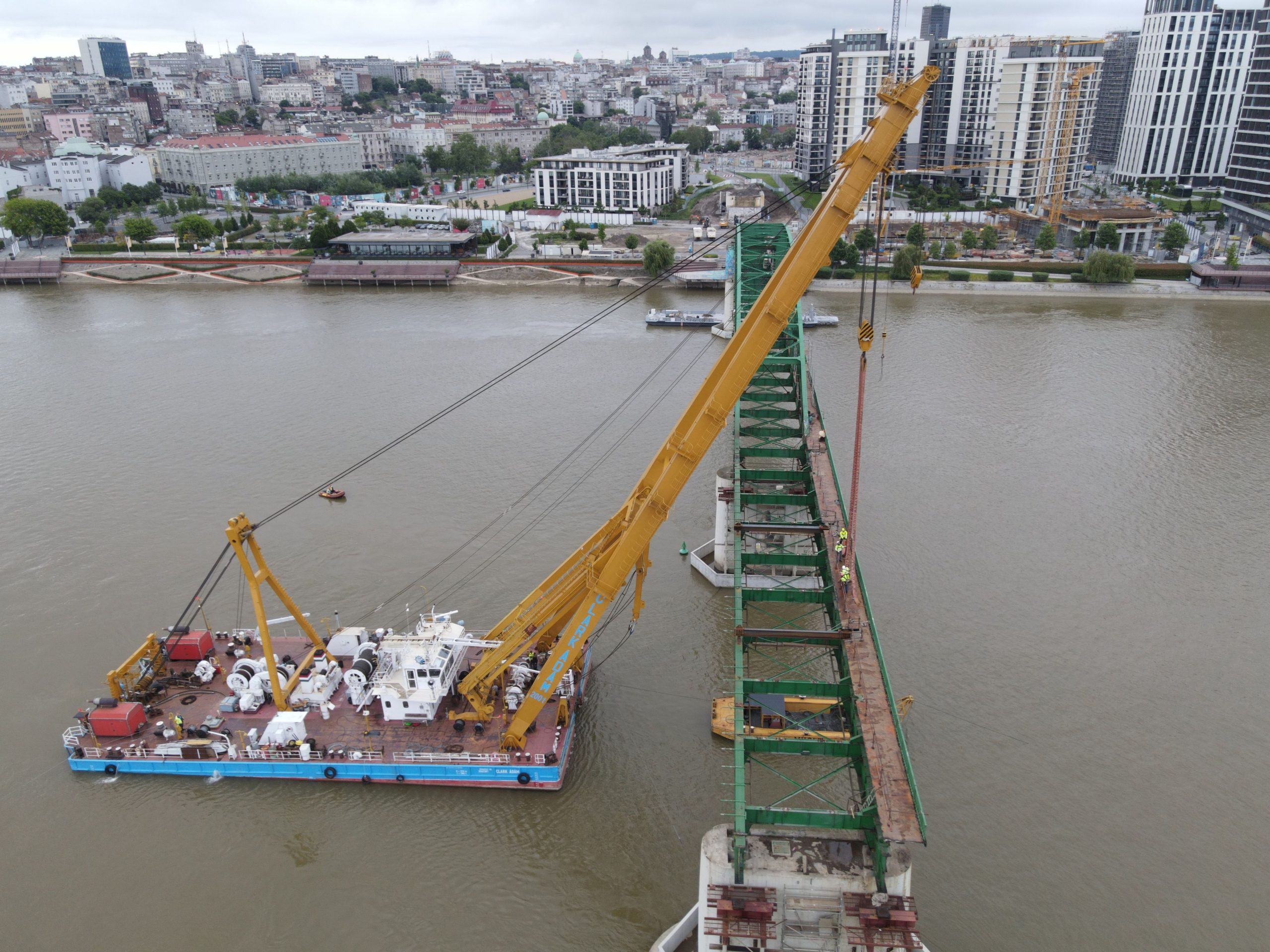

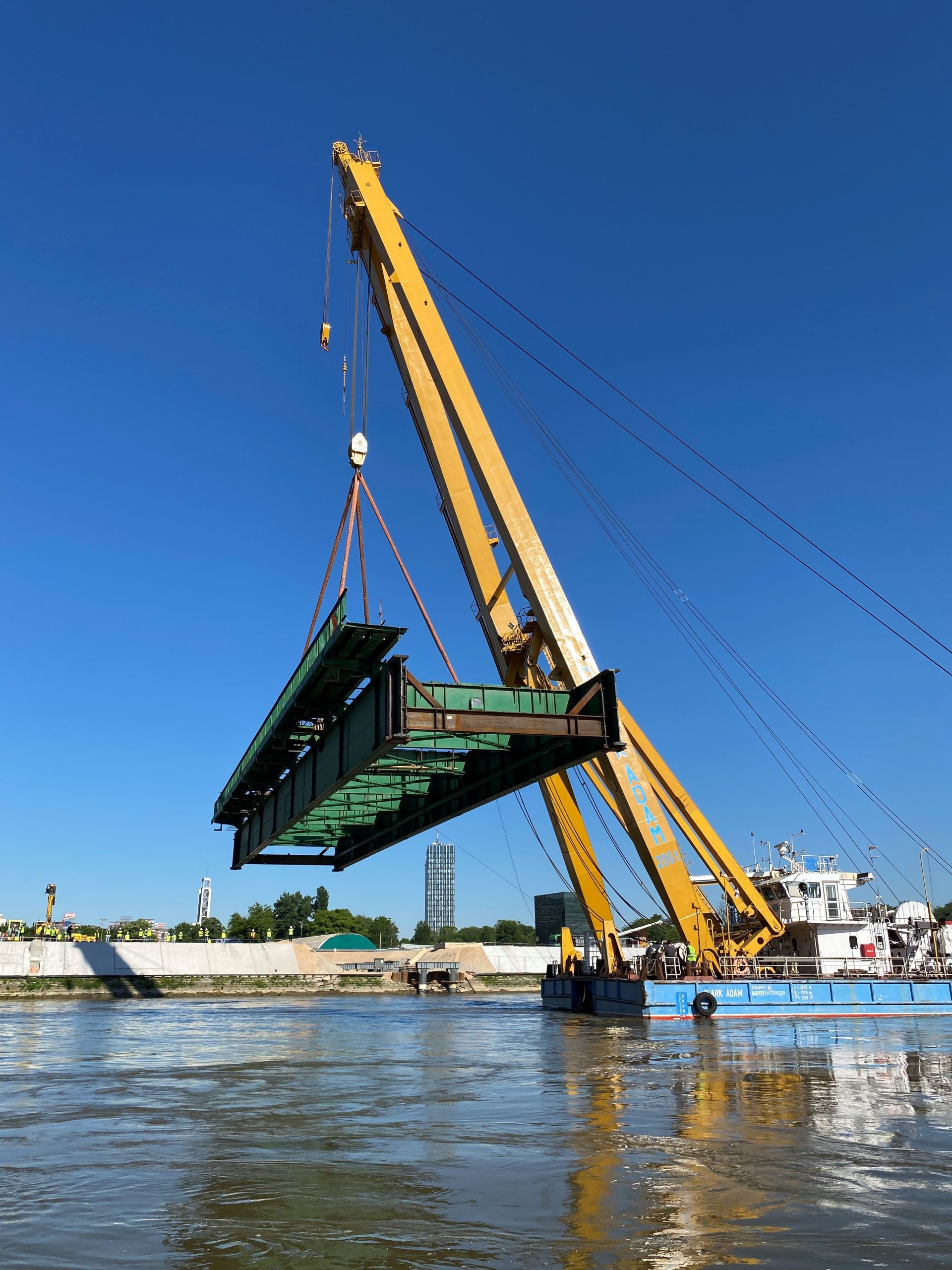

The dismantling of the Old Sava Bridge in Belgrade began with the phased removal of the bridge superstructure elements, preceding the later lifting of the arch span. During the works, three large-scale bridge sections had to be removed by floating crane operations carried out in multiple stages. The first phase involved the removal of the left-bank outer span. The approximately 112-ton steel structure was lifted from its position by the Clark Ádám floating crane. More than twenty specialists worked in close coordination during the operation, with vessel crews, rope access technicians, and engineers ensuring the precise execution of the lift. In the next phase, the second bridge section on the left bank was removed. With a weight of approximately 135 tons, this operation represented the largest lifting task of the project up to that point. Alongside the Clark Ádám floating crane, the entire marine fleet participated in the operation: the Botond push boat, TS80 barges, and support vessels continuously maintained the required positioning throughout the process. The rigging of the structure was carried out using rope access techniques. The third stage consisted of removing the outer span on the right bank, a structure similar in size and weight to the previous element, also approximately 135 tons. Following each lifting operation, the bridge sections were individually placed onto TS80 barges, where they were cut into smaller segments before being lifted ashore by floating crane. All operations were executed in multiple stages under continuous coordination. The successful and safe dismantling of the structures within the planned schedule was made possible through the close integration of floating crane operations, marine logistics, and rope access activities. |
Rušenje Starog Savskog mosta u Beogradu počelo je faznim demontažom gornje konstrukcije mosta, pre podizanja zadnjeg elementa samog luka mosta. Tokom radova, morali smo da pomerimo tri velika elementa mosta pomoću plutajuće dizalice, u nekoliko faza. Prvo je podignut spoljni element leve obale, čelična konstrukcija teška oko 112 tona. Podignuta je sa svog mesta pomoću plutajuće dizalice Klark Adam. Tokom izvođenja radova više od dvadeset stručnjaka radilo je koordinirano: mornari, alpinisti i inženjeri kako bi osigurali precizno izvođenje podizanja. Sledeća faza je bilo podizanje drugog elementa mosta na levoj obali, koji je sa svojom težinom od 135 tona, bio najveći kranski zadatak projekta do sada. Tokom podizanja, pored plutajuće dizalice Klark Adam, u radu je učestvovala cela flota: tegljač Botond, barže TS80 i servisni brodovi kontinuirano su obezbeđivali potreban položaj. Konstrukcije su prikačene za dizalicu uz pomoć alpinista i inženjera. Kao treći korak, podignut je krajnji element sa desne obale, što je bila konstrukcija težine približno 135 tona, slična prethodnom elementu. Nakon podizanja, elementi mosta su jedan po jedan postavljani na barže TS80, a zatim su jedinice elementa postavljene na obalu. Radovi su izvođeni u nekoliko koraka, uz kontinuiranu koordinaciju. Koordinacija plutajućih dizalica, zadataka navigacije i alpinističkih radova omogućila je bezbedno demontiranje konstrukcija planiranim tempom.
|
